Carson City
Home MenuFIND A SERVICE
EAST WILLIAM STREET PROJECT
Construction Update
Construction on the East William Street Project is underway, with Utility improvements and Complete Streets improvements progressing simultaneously. Utility work began in June 2025 and is anticipated to be completed in March 2026. Complete Streets construction began in November 2025 and will continue through fall 2026.
Repaving of E. William Street between Carson Street and Roop Street is planned for spring 2026, weather permitting. The full project is expected to be completed by fall 2026. All construction activities are weather-dependent and subject to change.
Utility Improvements (Completion: March 2026)

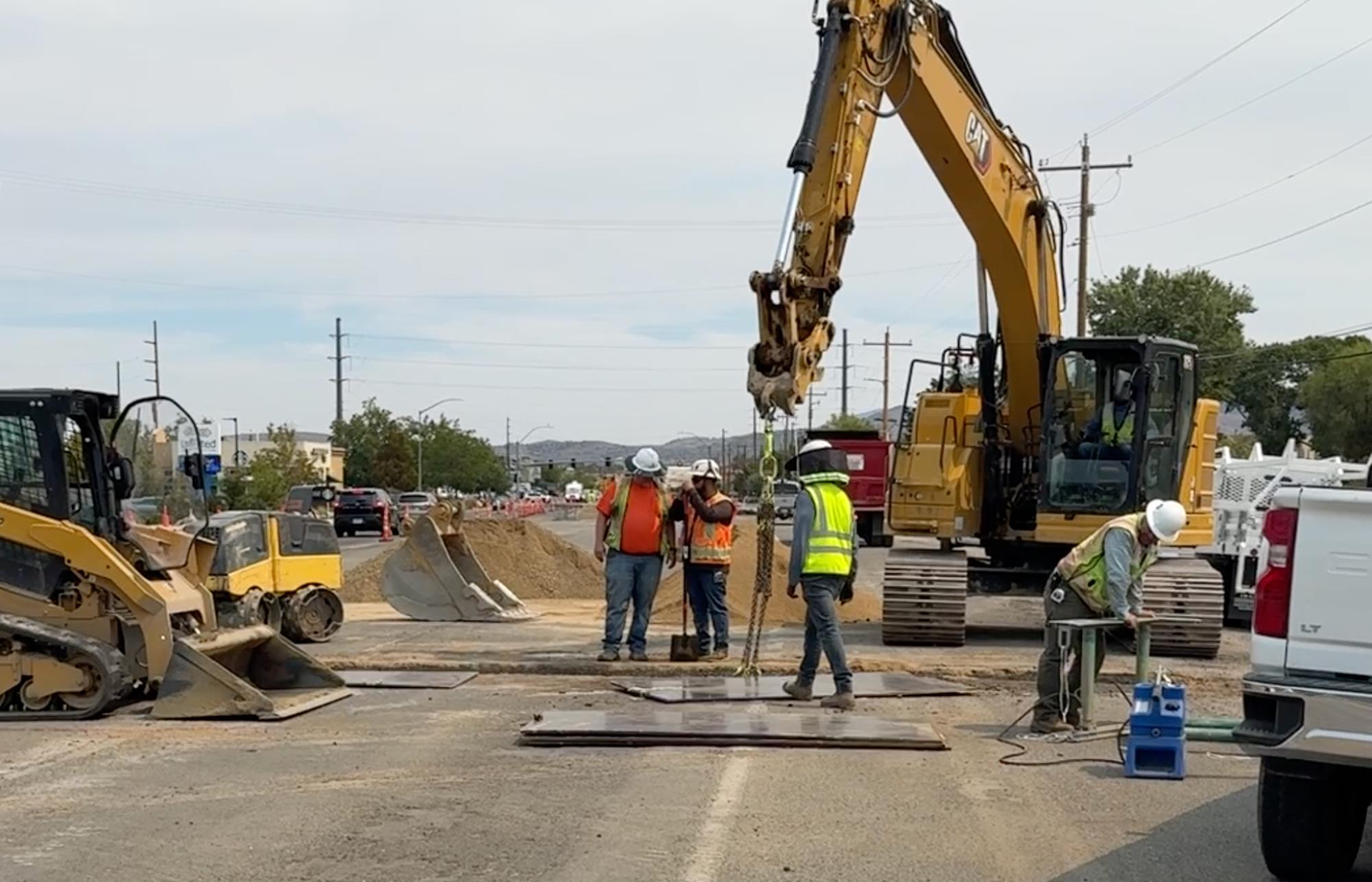

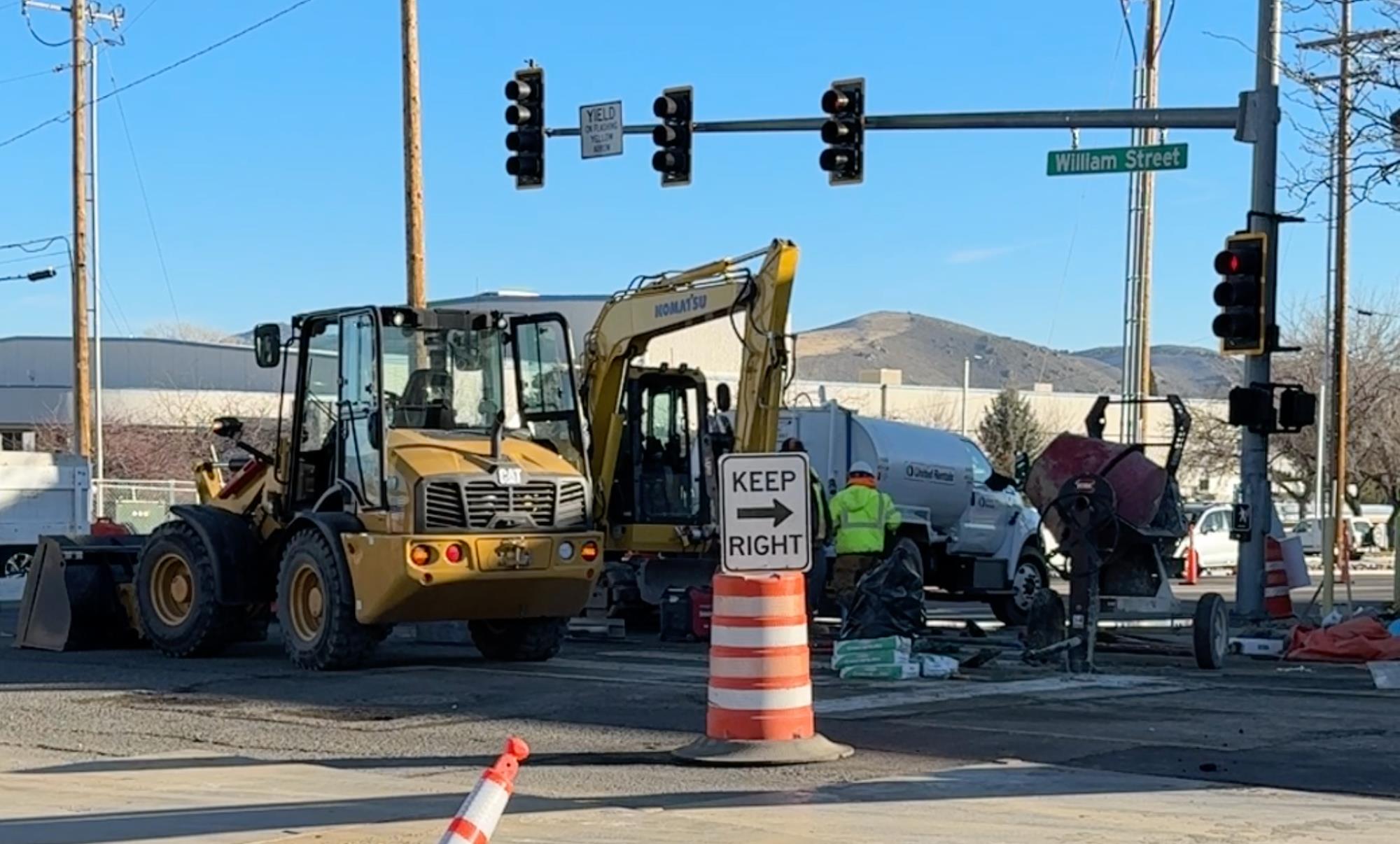

- Most utility work is complete
- Remaining milestones include waterline tie-ins and removal of existing powerlines (by NV Energy)
- Once complete, major traffic and access impacts will lessen until paving operations begin
Complete Streets Improvements (Completion: Fall 2026)
- Concrete work on the north side is complete
- South side concrete work will begin after utility activities finish
- Following concrete work: roadway milling and repaving, striping, landscaping, and finishing elements
Working Hours
Monday–Friday: 7 a.m. – 5:30 p.m.
- Traffic control may occur outside normal hours
- Occasional night work and full intersection closures during marathon weekends may occur with advance notice
Traffic Control

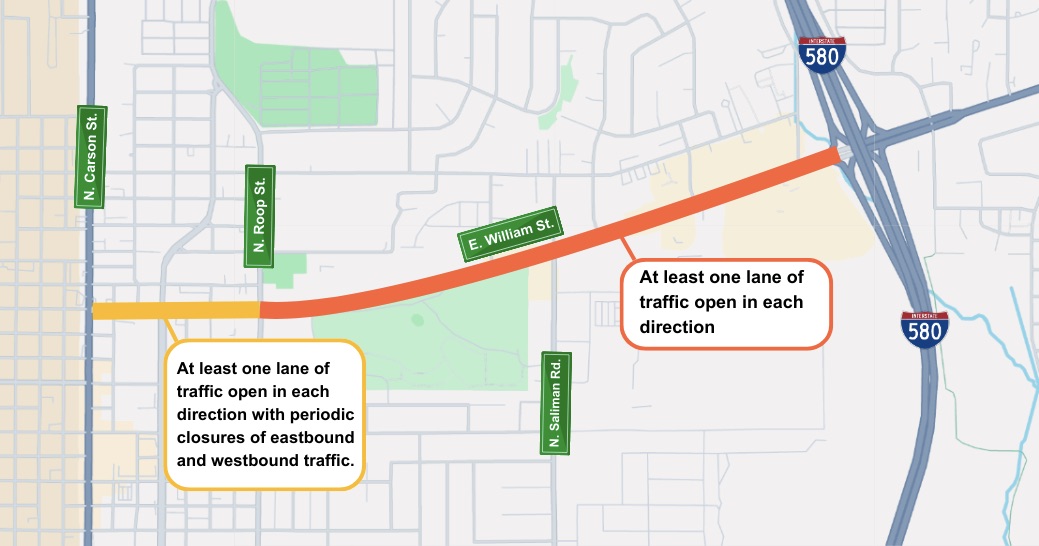

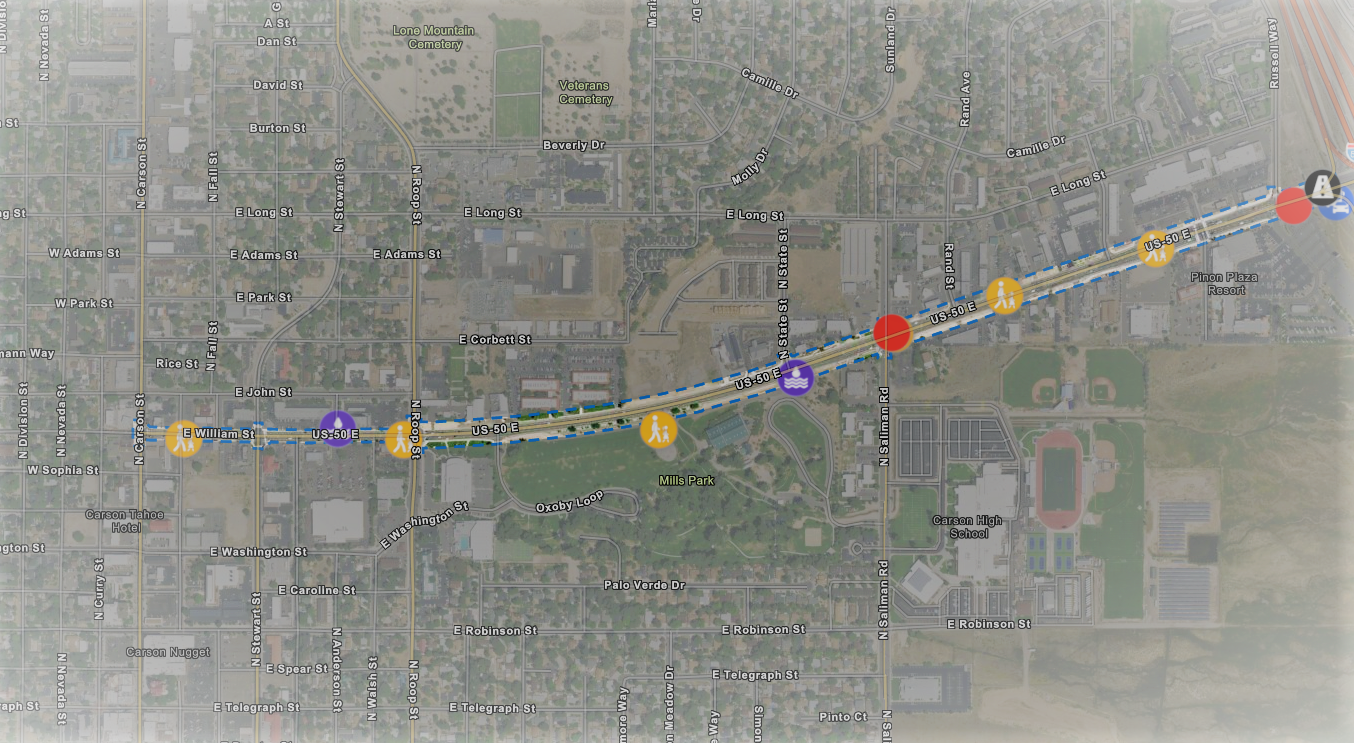

Traffic control and access will change throughout the project. The map below shows the general traffic control for the duration of the project.
Get weekly traffic control updates in the weekly Road Report available:
- On this interactive map
- On Carson City Public Works Facebook and Instagram pages
- On CarsonNow.org every Sunday
- On Saturdays in The Nevada Appeal’s print edition
Project Improvements

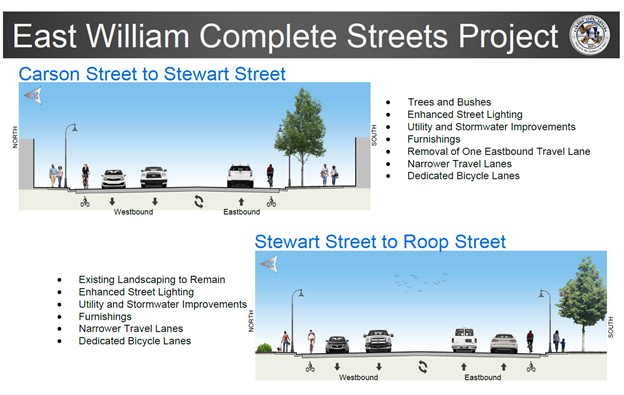

The project includes a complete corridor transformation of William Street between Carson Street and the I-580 interchange. Improvements include:
• Relocating overhead utilities to underground
• Replacing aging water infrastructure
• Installing storm drain to help prevent roadway flooding
• Removal and replacement of existing sidewalks and driveways
• Installation of new sidewalk for continuous connectivity
• Installation of new dedicated bike lanes
• Construction of a new 10-foot-wide multi-use path to increase corridor safety
• Removal and replacement of roadway asphalt
• Replacing traffic signals
• Installation of new street lighting
• Landscaping to beautify the corridor
